What Can Delay a Concrete Pour on the Day?

July 28, 2026

Planning for concreting in Hobart requires more than booking a concrete delivery. The truck, crew, pump, site preparation, inspections and weather conditions must all align for the pour to proceed safely and efficiently. Careful preparation before planning a concreting project can help prevent access, scheduling and site-readiness problems from emerging on pour day. Even when a project appears ready, access problems, unfinished work or unexpected site conditions can cause delays or force the booking to be rescheduled.

With extensive experience managing concrete projects, Con-Tek Concrete understands the factors that can affect a successful pour. This article explains the most common causes of pour-day delays and the practical steps builders and property owners can take to reduce disruption.

Site Access Problems for Trucks and Equipment

Concrete trucks and pumping equipment must be able to reach and operate at the site safely. Narrow access, unstable ground, overhead hazards or insufficient setup space can slow the delivery process or prevent the pour from proceeding.

Access planning should consider more than whether a truck can fit through the gate. The approach roads, driveway width, turning space, overhead clearance, ground conditions and distance between the truck and placement area all affect the setup.

Inadequate Space for Truck Entry and Setup

Concrete agitator trucks and pump trucks need more room than many residential and infill sites provide. Narrow driveways, tight cul-de-sacs, congested streets and limited turning areas can make it difficult for drivers to enter, reverse or position the truck safely.

Common obstructions include:

  • Vehicles parked along the access route
  • Skip bins or building materials blocking the setup area
  • Fences or scaffolding positioned closer than shown on plans
  • Gates that do not provide enough height or width
  • Limited space for trucks to queue between deliveries

When a line or boom pump is required, sufficient space must also be available for the pump, outriggers, delivery lines and exclusion zones. If the intended setup area is unsuitable, the crew may need to reposition the pump, extend the line or arrange alternative equipment.

Before pour day, the contractor should confirm:

  • The minimum access width and turning space required by the truck
  • The intended truck and pump positions
  • Suitable locations for truck queuing
  • Clearances around gates, scaffolding and temporary structures
  • The distance from the discharge point to the placement area

Planning for the safe setup of concrete pumping equipment helps ensure there is enough space for the pump, outriggers, pipelines and controlled work areas.

Weak or Unstable Ground

Concrete trucks and pumps place significant loads on driveways, crossovers and unprepared ground. Soft soil, poorly compacted fill, recent excavation or wet weather can increase the risk of vehicles becoming bogged or damaging the surface.

A supplier or pump operator may decline to enter an area if the ground cannot safely support the equipment. The concrete may then need to be discharged farther from the pour, requiring longer pump lines or additional manual handling.

Depending on the site, temporary ground protection may include:

  • Compacted crushed rock
  • Engineered access pads
  • Timber mats
  • Steel plates
  • Other support recommended by the equipment operator

These measures should be arranged before the first truck arrives.

Overhead Hazards and Traffic Restrictions

Powerlines, overhanging branches, building eaves and other overhead obstructions can restrict the movement of trucks or the operation of a boom pump.

Work near live electrical infrastructure may require minimum clearances, exclusion zones, permits or consultation with the relevant network operator. Where suitable controls have not been arranged, the pump may need to be repositioned or the pour postponed.

Sites on busy roads may also be affected by:

  • Heavy-vehicle restrictions
  • Road occupancy requirements
  • Traffic-control arrangements
  • Pedestrian-management requirements
  • Temporary road closures
  • Restricted delivery times

Confirming permits, traffic plans and overhead clearances in advance reduces the risk of trucks arriving without being able to access the site.

Incomplete Formwork, Reinforcement or Site Preparation

A pour should not proceed until the formwork, reinforcement, excavation and supporting base have been checked and found suitable. Discovering incomplete or incorrect work after the concrete has arrived can lead to waiting charges, cancelled loads and rescheduling costs.

Formwork Not Ready

Formwork determines the shape, height and finished levels of the concrete. It should be fully erected, braced and checked before delivery.

Problems that may delay a pour include:

  • Gaps that could allow cement slurry to escape
  • Missing or loose pegs, stakes or bracing
  • Incorrect edge heights or screed levels
  • Forms that do not match the approved dimensions
  • Standing water, mud, debris or contamination inside the forms

Formwork adjustments can be time-consuming, particularly when several levels, steps or drainage falls need to be reset. Completing these checks before the truck arrives gives the crew enough time to make corrections without disrupting the delivery schedule.

Reinforcement Issues and Inspection Hold Points

Reinforcement should be installed, supported and tied in accordance with the approved drawings. Common problems include:

  • Incorrect bar spacing
  • Inadequate concrete cover
  • Mesh laps that do not meet the design
  • Missing or unsuitable bar chairs
  • Incorrectly positioned starter bars or hold-down bolts
  • Services or penetrations placed in the wrong location

Some projects require reinforcement or footing inspections before concrete can be placed. If the inspection has not been booked, has not been completed or identifies non-compliant work, the pour may need to be delayed until corrections and reinspection are completed.

Reinforcement should not be repositioned after concrete placement has begun unless the work is being completed under an approved procedure and appropriate professional direction.

Excavation, Subgrade and Base Problems

The excavation and supporting base must match the required depth, level and design. Issues commonly identified on pour day include:

  • Over-excavation that increases the required concrete volume
  • Areas that have not been excavated deeply enough
  • Soft spots or poorly compacted fill
  • Saturated ground following rain
  • Mud or debris on the vapour barrier
  • Incorrect step levels or footing depths
  • Incomplete preparation around service penetrations

Placing concrete over unstable or contaminated ground can affect settlement, support and long-term performance. Where problems are found, the area may need to be dried, regraded, recompacted or replaced before work can continue. Professional site excavation and preparation helps establish a stable, correctly graded base before formwork and reinforcement are installed.

Drainage, Levels and Falls Requiring Correction

Concrete is difficult and expensive to correct after it has hardened. Finished levels and drainage falls should therefore be checked carefully before placement.

Incorrect Finished Levels

Formwork sets the final height of slabs, edges, steps and transitions. Errors can create problems where the new concrete meets:

  • Door thresholds
  • Garage slabs
  • Existing driveways
  • Patios and alfresco areas
  • Paths or landscaping
  • Internal floor finishes

For example, a garage slab that finishes above the driveway or an external patio that sits too close to an internal floor level may create drainage and water-entry risks.

Rectification can involve resetting forms, adjusting the prepared base and rechecking the entire area with a laser level. Depending on the extent of the problem, the pour may need to be moved to a later time.

Insufficient or Incorrect Falls

External concrete should direct water towards the nominated drainage point without allowing water to pond against buildings or across trafficable areas.

Delays may occur when checks identify:

  • Falls directing water towards the house
  • Insufficient slope towards a strip drain or pit
  • Flat areas where water is likely to collect
  • Multiple falls that have not been shaped correctly
  • Drainage points positioned at unsuitable levels

Required falls should be confirmed against the approved plans, drainage design and applicable building or council requirements. They should not be assumed using a single standard measurement for every project.

Corrections may require the crew to add or remove base material, recompact the surface, adjust formwork or alter the drainage layout.

Weather and Site Conditions

Weather can affect concrete placement, finishing, curing and strength development. A pour may need to be delayed when conditions create an unacceptable risk to quality or worker safety.

Heavy Rain and Standing Water

Light showers may sometimes be managed with suitable preparation, but persistent or heavy rain can make placement impractical.

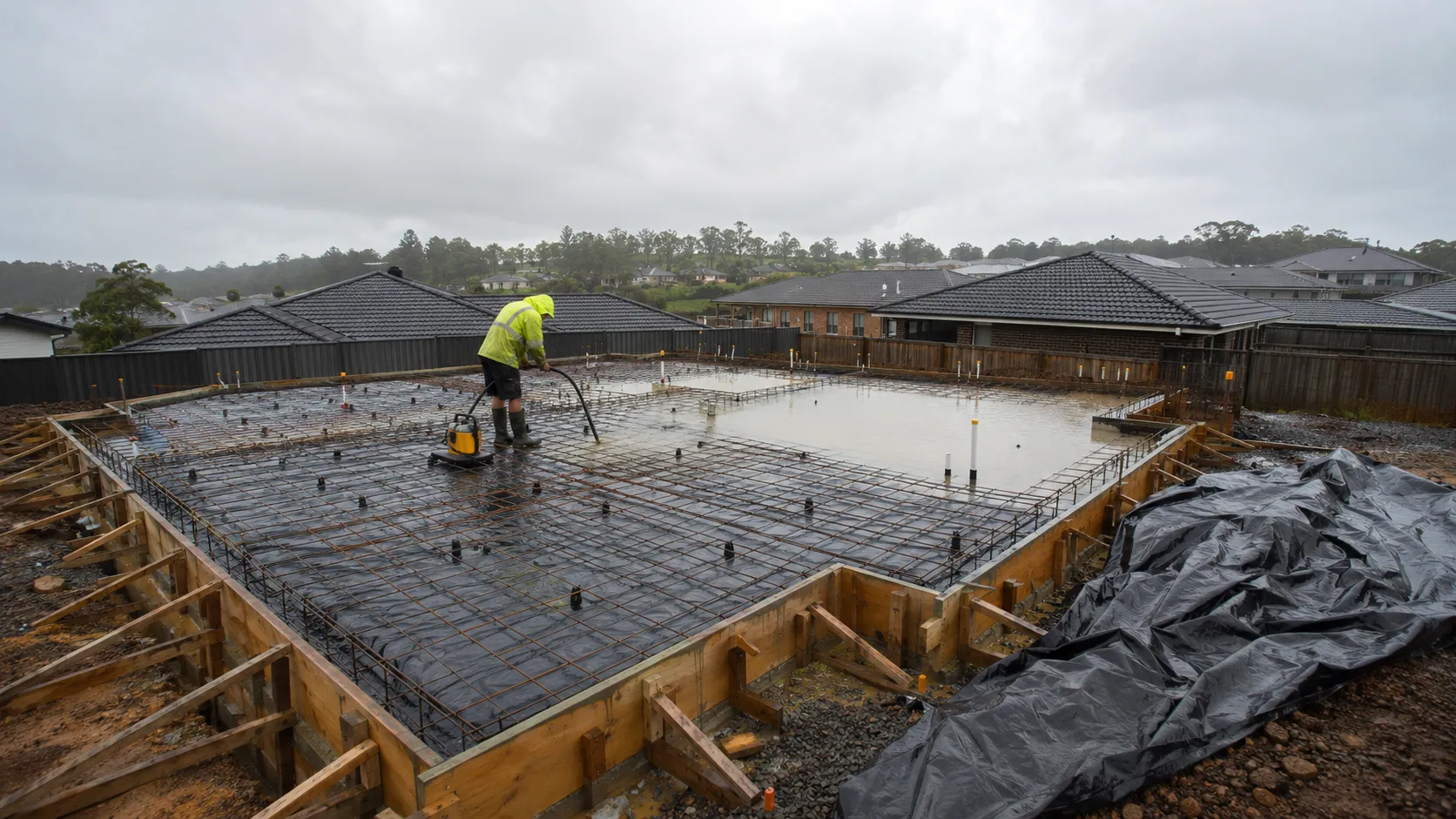

Standing water in footings, trenches or formwork should be removed before concrete is placed. Excess water can contaminate the surface, interfere with the concrete mix and contribute to a weak or uneven finish.

Rain falling on newly placed concrete can also:

  • Mark or pit the surface
  • Wash cement paste from exposed areas
  • Create erosion channels
  • Affect decorative finishes
  • Delay finishing and curing operations

Protective sheeting, temporary covers and drainage measures should be prepared when unsettled weather is forecast. However, protection may not be sufficient during sustained heavy rainfall.

Hot, Dry or Windy Conditions

High temperatures, low humidity and strong wind can cause moisture to evaporate rapidly from the concrete surface. This increases the risk of plastic shrinkage cracking and can shorten the available time for screeding, edging and finishing.

Risk-reduction measures may include:

  • Starting the pour earlier in the day
  • Increasing the number of workers
  • Providing shade or wind protection
  • Preparing curing materials in advance
  • Using an appropriate supplier-approved mix or admixture

The concrete supplier and contractor should determine whether the forecast conditions require changes to the timing or mix specification.

Cold Conditions and Frost

Cold weather slows setting and early strength development. In Hobart, low overnight temperatures and frost can also affect the prepared base, formwork and curing process. Avoiding common cold-weather concreting mistakes is particularly important when low temperatures, frost or extended setting times are expected.

Potential problems include:

  • Frost or ice on the subgrade
  • Longer finishing times
  • Slower early strength gain
  • Extended protection requirements
  • Delayed removal of formwork
  • Increased exposure to later rain or cold conditions

The site may require insulation, temporary covers, revised curing arrangements or a supplier-approved mix adjustment. Concrete should not be placed on frozen or unsuitable surfaces.

Concrete Supply and Delivery Delays

Even when the site is fully prepared, delays at the batching plant or on the road can disrupt the schedule.

Concrete deliveries are usually planned in a sequence so that each truck arrives as the previous load is being placed. Significant gaps can leave workers waiting and may increase the risk of visible joints or inconsistencies between loads.

Common Causes of Delivery Delays

Delivery windows can be affected by:

  • Traffic congestion or road incidents
  • Truck or batching-plant breakdowns
  • Material shortages
  • Quality-control issues at the plant
  • High demand during peak construction periods
  • Road closures or vehicle restrictions
  • Queues at the site entrance
  • Incorrect directions or contact details

The site must also be ready to receive each load. Where a truck cannot discharge within the agreed period, the supplier may need to redirect it or apply waiting charges.

Incorrect Quantities or Late Order Changes

Underestimating the required volume can interrupt a continuous pour while an additional load is arranged. Over-excavation, uneven ground and last-minute changes to slab dimensions can all increase the quantity needed.

Late changes to the specified strength, slump, aggregate, colour or admixtures may require a new batch or revised delivery schedule. Any permitted onsite adjustment should be authorised and controlled by the concrete supplier.

To reduce delivery risk:

  • Confirm the final volume and mix specification before pour day
  • Include an appropriate allowance for site variations
  • Provide accurate directions and access instructions
  • Supply a reliable site contact number
  • Agree on truck intervals with the supplier
  • Consider local traffic conditions when selecting the start time
  • Ensure the crew and equipment are ready before the first delivery

For critical pours, requesting an early delivery slot may reduce the risk of delays from earlier bookings affecting the schedule.

Last-Minute Design or Finish Changes

Changes requested shortly before the pour can affect formwork, reinforcement, concrete volume, equipment and labour requirements.

Changes to Layout, Levels or Thickness

Altering the footprint of the slab, the position of a step-down or the location of a service penetration can require formwork to be dismantled and rebuilt.

Increasing slab thickness may also mean:

  • The ordered volume is no longer sufficient
  • Reinforcement no longer has the required cover
  • Edge forms are too low
  • Excavation depths need to be revised
  • Engineering details need to be updated

Even a relatively small adjustment can affect several parts of the preparation.

Structural or Reinforcement Changes

Late structural changes may require additional bars, trench mesh, starter bars or thickened edges. The crew may need revised drawings or written instructions before proceeding.

If the correct reinforcement is not available onsite, the pour may need to be rescheduled while materials are sourced and inspections are rearranged.

Finish, Colour or Mix Changes

Changing from plain concrete to exposed aggregate, coloured concrete, a burnished finish or decorative stencilling can alter:

  • The concrete specification
  • Placement and finishing times
  • Labour requirements
  • Required tools and materials
  • Curing and sealing procedures

These decisions should be finalised before the order is confirmed. Specialist finishes may also require dedicated contractors who need to be booked in advance.

Approvals, Inspections and Underground Services

Administrative and compliance issues can delay a project even when the physical site appears ready.

Before booking the pour, confirm that:

  • Relevant planning and building approvals have been issued
  • Engineering drawings are final
  • Design revisions have been incorporated onsite
  • Required inspections have been completed
  • Inspection hold points have been released
  • Control-joint locations have been confirmed
  • Underground services have been investigated

Obtaining Before You Dig Australia plans is an important first step, although onsite locating may still be required to confirm the position of underground assets. Asset-owner instructions should also be reviewed before excavation or ground preparation begins.

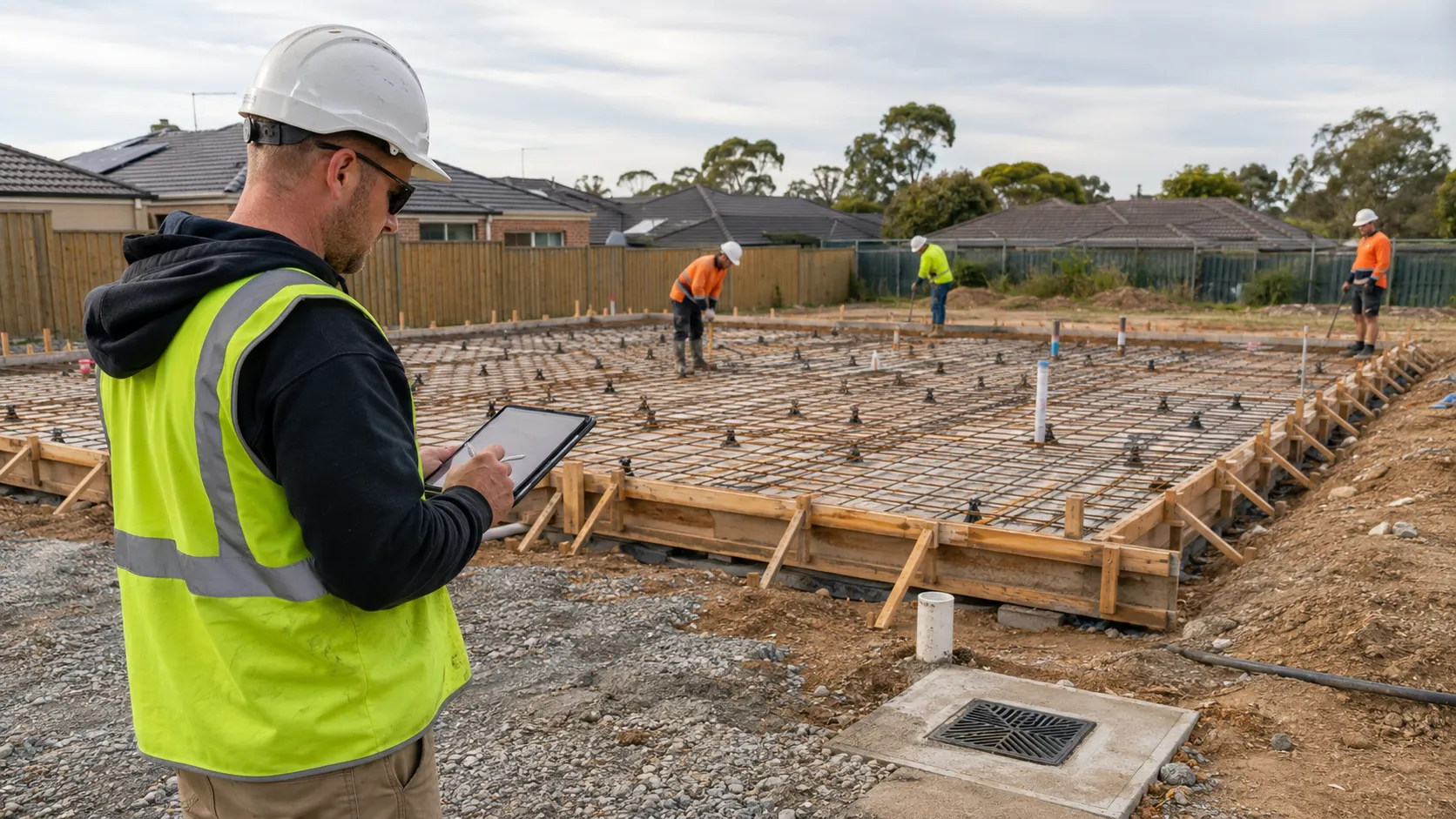

Pre-Pour Checklist

A final inspection should be completed before the concrete truck is due. The following checklist can help identify avoidable problems.

Access and Equipment

  • Truck access is clear and suitable for the expected vehicle size
  • Pump position and outrigger support have been confirmed
  • Overhead hazards and electrical clearances have been assessed
  • Traffic-control or road-occupancy requirements are in place
  • Delivery lines, wheelbarrows and other placement equipment are ready
  • A suitable concrete washout area has been arranged

Site Preparation

  • Excavation depths and base levels have been checked
  • Soft or wet areas have been rectified
  • The base has been compacted as required
  • Formwork is complete, secure and clean
  • Reinforcement is installed and supported correctly
  • Service penetrations and cast-in items are in position
  • Vapour barriers and membranes are intact

Levels and Drainage

  • Finished heights match adjoining surfaces
  • Steps and set-downs match the drawings
  • Drainage falls have been checked
  • Pits and strip drains are at the correct level
  • Water will be directed away from buildings

Approvals and Coordination

  • Engineering and building documentation is current
  • Required inspections have been signed off
  • Underground services have been located
  • Concrete quantity and mix details have been confirmed
  • Truck intervals and delivery times have been agreed
  • The placing and finishing crew is confirmed
  • Site contact details have been provided to the supplier

Weather and Protection

  • The latest forecast has been reviewed
  • Rain covers or temporary shelter are available where appropriate
  • Curing materials and water are ready
  • Hot-, cold- or windy-weather controls have been discussed
  • A decision-maker is available if conditions change

Plan Ahead for a More Reliable Concrete Pour

Successful concrete pours depend on preparation rather than luck. Access, ground conditions, formwork, reinforcement, levels, weather, inspections, equipment and delivery timing all influence whether work proceeds smoothly.

Many delays can be avoided by completing a detailed pre-pour inspection, resolving design questions early and maintaining clear communication between the builder, engineer, concrete supplier, pump operator and finishing crew. Final decisions about structural readiness, concrete specifications and weather suitability should be made by the appropriate qualified professionals.

Con-Tek Concrete can assist with site preparation, access planning and pour-day coordination for concreting projects in Hobart. Addressing potential issues before the concrete arrives helps reduce avoidable delays and supports a safer, more efficient and higher-quality result.
